Case Study: Redbud Estates Gardens – Celina, TX
HomeCase StudiesCase Study: Redbud Estates Gardens – Celina, TX

Case Study

Case Study: Redbud Estates Gardens – Celina, TX

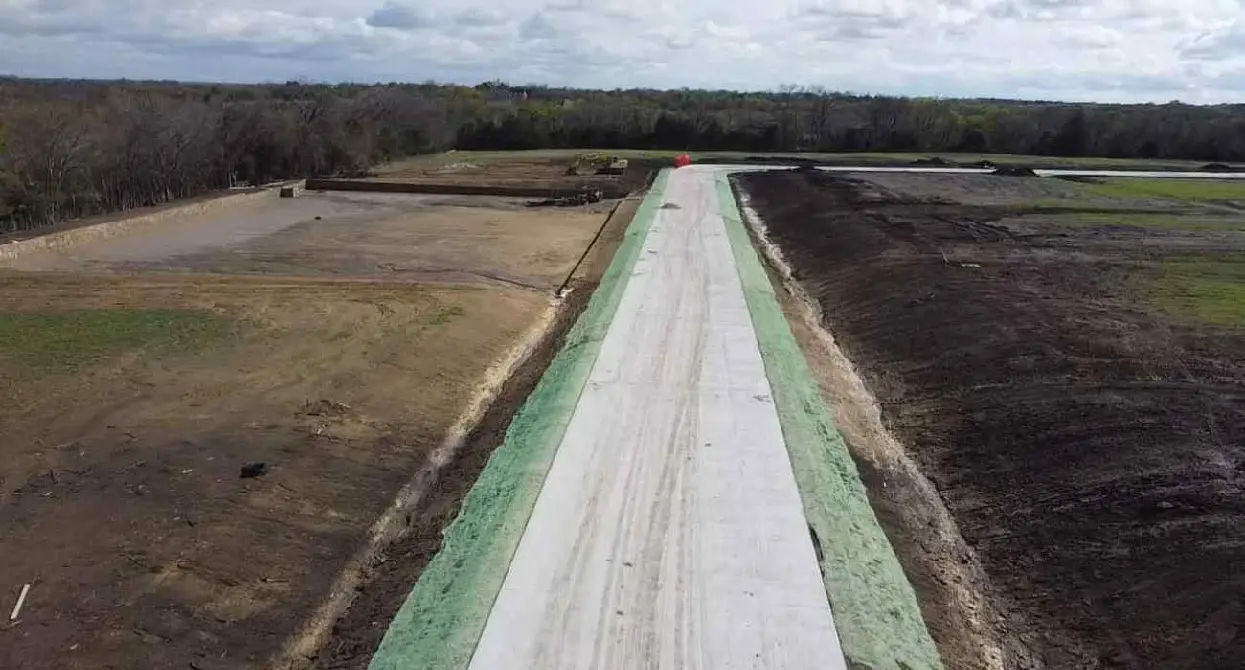

TX Sparks Construction was awarded the complete design, entitlement, and land development scope for Redbud Estates Gardens in Celina, TX — a complex project involving zoning changes, thoroughfare constraints, multi-agency coordination, and strict contractual timelines with the end home builder.

Case Study: Redbud Estates Gardens – Celina, TX

Entitlement, Permitting & Land Development Excellence by TX Sparks Construction

Project Overview

Project Name: Redbud Estates Gardens

Location: Celina, Collin County, Texas

Project Type: One-Acre Single-Family Residential Lots

Client: Private Developer & Home Builder

Scope: Entitlements • Zoning • Permits • Land Development • Construction Management

TX Sparks Construction was awarded the complete design, entitlement, and land development scope for Redbud Estates Gardens — a complex project involving zoning changes, thoroughfare constraints, multi-agency coordination, and strict contractual timelines with the end home builder.

Despite the challenges, TX Sparks delivered the project successfully using our structured methodology, proactive stakeholder management, and technology-driven execution model.

Key Challenges

  • Zoning change and complex entitlement approvals
  • Thoroughfare alignment across the property
  • Strict development timeline with builder under contract
  • Multi-agency coordination (Collin County, utilities, water authority, power providers)
  • Budget optimization while maintaining design quality

TX Sparks Methodology & Execution Framework

1. Strategic Pre-Development Planning

We assembled a specialized civil engineering team with deep experience in Collin County regulations and review processes.

A detailed master schedule was created aligning:

  • Civil engineering timelines
  • Third-party studies
  • County approval cycles
  • Utility coordination
  • Client and builder deadlines

2. Budget-Driven Design Optimization

Our design team worked closely with the client to continuously refine plans, ensuring:

  • Code compliance
  • County acceptance
  • Cost efficiency
  • Builder constructability

This value-engineering approach allowed us to meet budget goals without sacrificing performance or quality.

3. Government & Agency Alignment

Early pre-development meetings with Collin County established a strong working relationship and clear expectations for:

  • Plan review process
  • Approval sequencing
  • Submittal requirements
  • Communication protocols

We also coordinated extensively with Mustang Water and all dry utility providers, aligning their schedules with our master project timeline.

4. Iterative Design & Review Cycle

Every week our in-house design team conducted internal reviews with:

  • Construction managers
  • Civil engineers
  • Third-party consultants
  • Utility partners

This eliminated unnecessary revisions and ensured submission packages were accurate, complete, and approval-ready.

5. Accelerated County Approvals

When county and third-party reviewers experienced delays due to project backlogs, TX Sparks leadership met with county officials in person, clearly communicated project constraints, and secured prioritized review — protecting the client’s contractual timeline.

6. Technology-Driven Construction Management

Once permits were issued, we mobilized:

  • Earthwork crews
  • Utility contractors
  • Concrete & paving teams
  • Landscaping teams

All parties were onboarded into our AI-powered construction management platform, providing:

  • Centralized schedules
  • Daily logs
  • Inspections
  • RFIs & submittals
  • Financial tracking
  • Real-time mobile access for every stakeholder

7. Risk Management & Field Engineering

During construction, we discovered discrepancies between approved water outlet drawings and actual site conditions.

TX Sparks immediately:

  • Deployed civil engineering verification
  • Corrected as-built documentation
  • Resubmitted revised plans to the county
  • Eliminated future risk for the client and builder

8. Transparent Reporting & Lender Confidence

Our monthly Field & Financial Reports included:

  • Last 30 days of daily logs
  • Photos & video documentation
  • Signed lien waivers
  • Pay applications
  • Submittals & inspections
  • Change documentation

Lenders specifically noted this was the most detailed and professional reporting system they had ever reviewed.

9. Final Delivery & Post-Construction Support

After final inspections and minor field adjustments requested by county inspectors, TX Sparks delivered:

  • Fully developed lots
  • Complete as-built documentation
  • Warranty information
  • Inspection records
  • Full digital project archive

Even months later, when the builder requested additional utility and ISP documentation, our centralized system allowed immediate response.

Project Outcome

✔ On-time entitlement & permitting

✔ Budget-controlled development

✔ Zero legal disputes

✔ Strong county & agency relationships

✔ Exceptional lender & client satisfaction

✔ Fully delivered shovel-ready lots to home builder

Why This Matters for Future Clients

This case demonstrates how TX Sparks:

  • Protects developer timelines
  • Reduces entitlement & permitting risk
  • Controls construction costs
  • Maintains legal & financial transparency
  • Uses advanced technology for total project visibility
  • Delivers consistent, predictable results
← Back to all Case Studies

Get in touch

Connect with the construction partner you deserve.

Building blueprints with precision. Let's start your journey

Contact us

Explore Brochure

Download Our Service Brochures.

Learn more about what we build and how we deliver.

Ground-Up Construction

Download

Interior Build-Out

Download

Land Development

Download
